ᐅ Inspired by "The Mandalorian": This is the plan.

Created on: 13 Mar 2022 10:23
P
Pinkiponk
We are making progress, so hopefully I can soon contribute something to the subforum "Show Us Your Houses." For now, we are sticking to the plan, see attached. (I have noticed that two of the calendar week references are not correct.) We are building in the Leipzig district, postal code 0457x. If anyone has time and interest and would like to watch, please send me a message.* 🙂

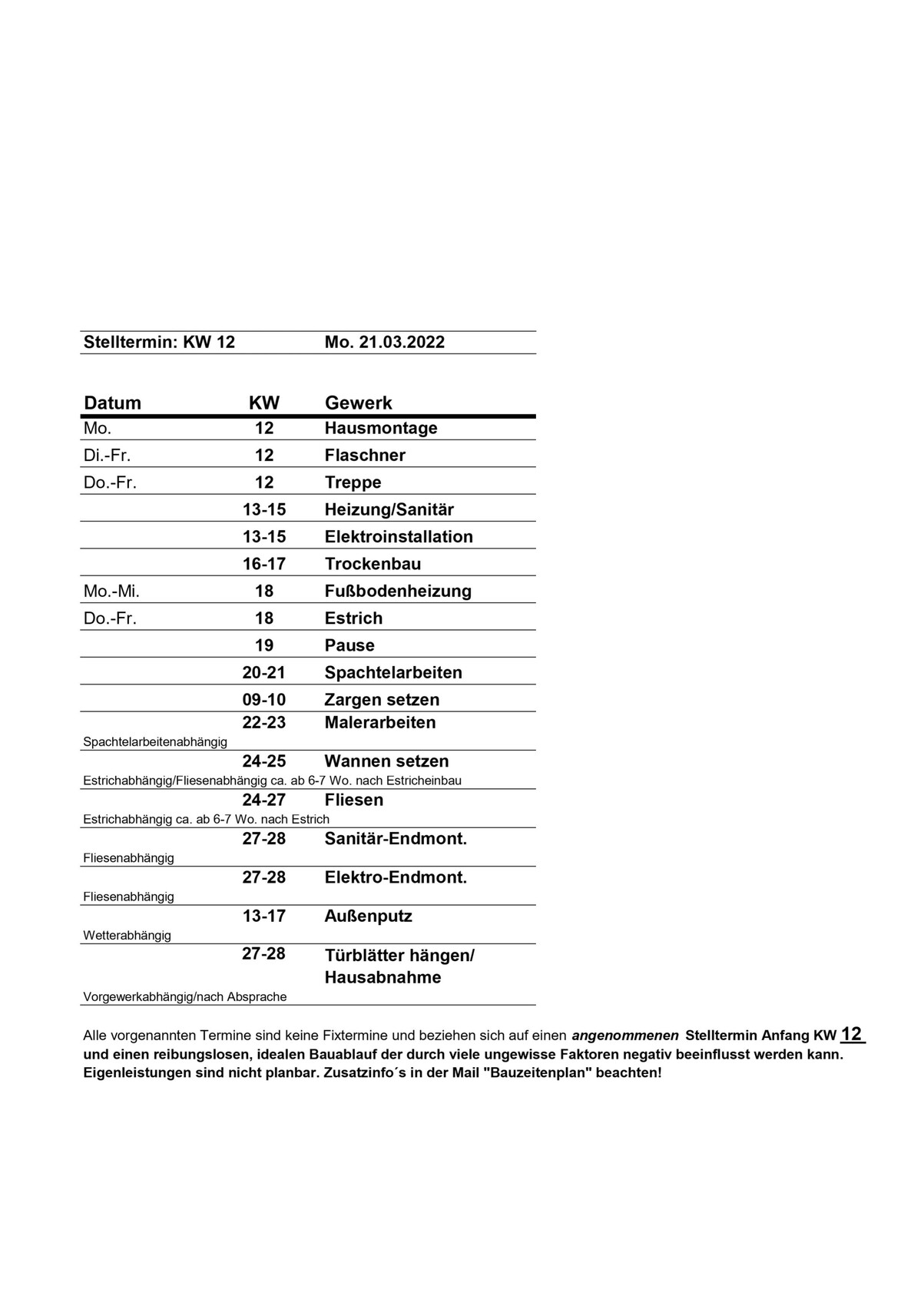

Construction schedule week 12: date, week, trade, and tasks (e.g., assembly).


*@Moderator: I hope this is allowed. If not, please let me know. Thank you. 🙂
S
SoL
14 Mar 2022 14:57
netuser schrieb:

A drying time of 6-7 weeks is planned.
Aren’t the plastering and painting works included in those 6 to 7 weeks? Or am I misunderstanding?

But since it’s anhydrite screed anyway, that should be fine.
debaser14 Mar 2022 15:29
Pinkiponk schrieb:

He often says, "That's the plan." ;-)
He actually tends to say, "That's the way." 😉
P
Pinkiponk
14 Mar 2022 16:15
debaser schrieb:

He actually says more like "This is the way." 😉
Really? Oh, how embarrassing, I’ll have to check again. I could try to excuse myself with my "loosely based on ..." but I won’t—I admit my mistake and thank you for the correction. Misquoting can be funny sometimes, but other times it can be a serious issue. ;-)
debaser14 Mar 2022 16:40
Could be worse – it’s definitely a good series, so it’s worth watching again anyway 🙂

About the plan: I actually had to look up what a "Flaschner" is – I’ve never heard that term before. Here it’s called a roofer or sheet metal worker, and I thought it was the same everywhere 😀
I’m keeping my fingers crossed that everything goes according to plan!
11ant14 Mar 2022 16:46
debaser schrieb:

I just had to look up what a "Flaschner" is – I've never heard that term before. Here, it's called a plumber or sheet metal worker, and I thought that was the case everywhere.

Butcher, meat cutter, bone settler; Becker / Brodbeck, Ziegler / Steinbeck, even the name Hoffmann is Meier in most regions.
https://www.instagram.com/11antgmxde/
https://www.linkedin.com/company/bauen-jetzt/
